Project Settings - Project Cost Setup
Project Cost Set Up - Showing
Two Options for Materials | Equipment | Specialty Items
Project Cost can be set up with cost and percentages. The Best way is to
Export Price List to Excel and then Import it back into the program to convert
to the .bdata file.
Setting up the Price List to Include Cost for the following:
Materials
Equipment
Specialty Items
Example of Price List with Cost Applied: Apply the actual cost in the cost columns on the Excel Spreadsheet as Shown
Below

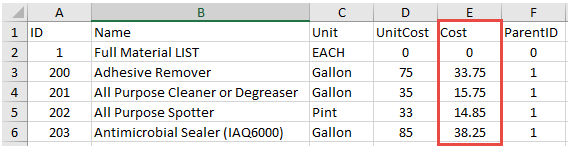

Materials Cost
Equipment Cost

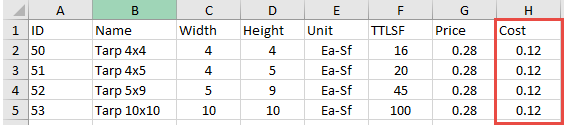

Specialty Items Cost (Tarps)
COST AS PERCENTAGE FOR MATERIALS | EQUIPMENT | SPECIALTY
ITEMS
- You can Also Use the Percentage Function instead of the Actual Cost as shown
above

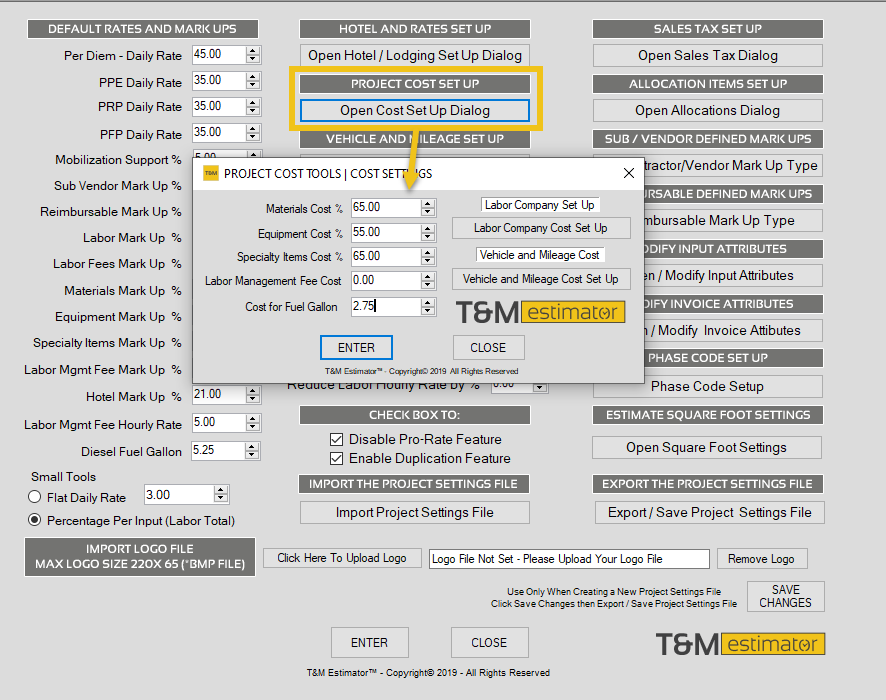

- Open the Cost Set Up Dialog - See image below
- Enter the Percent for Materials, Equipment and Specialty Items - See Example
Below
- When you us this method, it calculates the cost based on the percentages you
entered here
- You can also enter your cost for Labor Management (if applicable) and the cost of Diesel Fuel. These are NOT a percentage.
Labor Cost Setup - This is done on the Project Settings -
See Below
Labor Cost is defined per Labor Class - This will calculate cost against the
labor class being billed. It is never a good idea to put an employees real cost
down as it can be viewed by others. So the rule of entering labor cost is by an
overall average. The purpose of the cost module to give a project manager a
tool to manage a projects cost since most accounting systems are several weeks
behind a project.
To Set Up Labor Cost
Open the Labor Company Cost Set Up - See Image Below

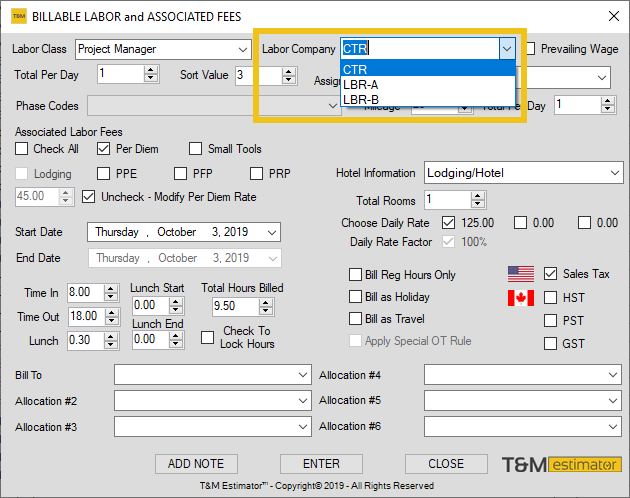

Click ADD on the Cost (LABOR) Dialog
Enter the Company or Abbreviated Company Name the Labor Works for
Choose Labor Class
Fill out the Information for Regular Rate and OT Rate Factor you are
paying
You have to do this for Every Labor Class and Every Company you will be
scheduling Labor for working on the Project
Each Time you Enter a Labor it will Post in the Cost Table as shown
below
We always recommend you select OT Rule as Billed - As this will follow the
same OT Rule you are using in the bill
- Once you have all Labor Classes Completed (You can just do the labor
classes you will be using in the bill)
- You will need to pick the labor company for each labor input and it will post
the cost to the Project Cost Manager.
